SUSTAINablility increase of lightweight, multifunctional and intelligent airframe and engine parts

Periodic Reporting for period 3 - SUSTAINair (SUSTAINablility increase of lightweight, multifunctional and intelligent airframe and engine parts)

Período documentado: 2024-01-01 hasta 2024-06-30

GANTT chart of project

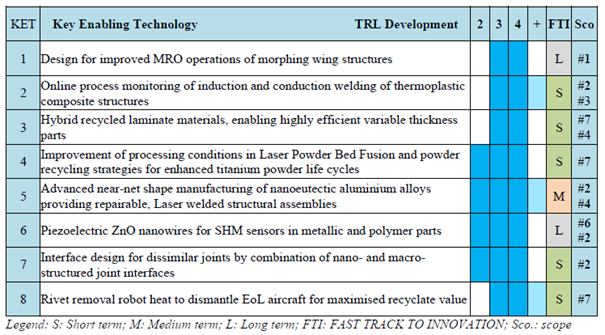

Infographic includes also paramount targeted scope issues and assessment of contribution to FTI

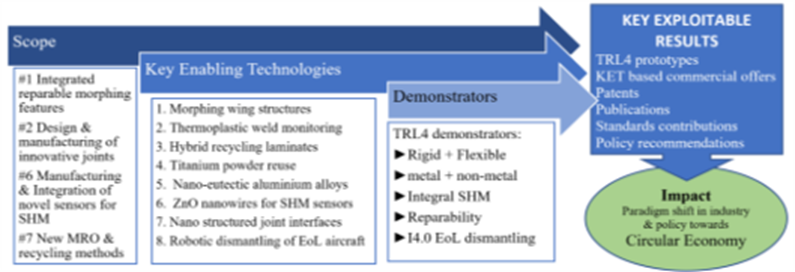

Infographic showcasing SUSTAINair approach to create impact
5 SUSTAINair S&T objectives
